Australian working day use cases
See how people use the calculator to plan court filings, respond to payment claims and arrange property settlements. Each example shows the settings and result. For help using the calculator, see the Australian guide.
Contents
Head contractor: SOPA payment schedule response deadline (NSW)
A head contractor is served with a payment claim on 18 December 2026 for a Sydney project. The contractor disputes part of the amount and needs to provide a payment schedule explaining what they will pay and why. They have checked that the contract does not require a response sooner than the 10 business days allowed by section 14 of the NSW Act. The Christmas exclusions affect when the schedule must be provided.

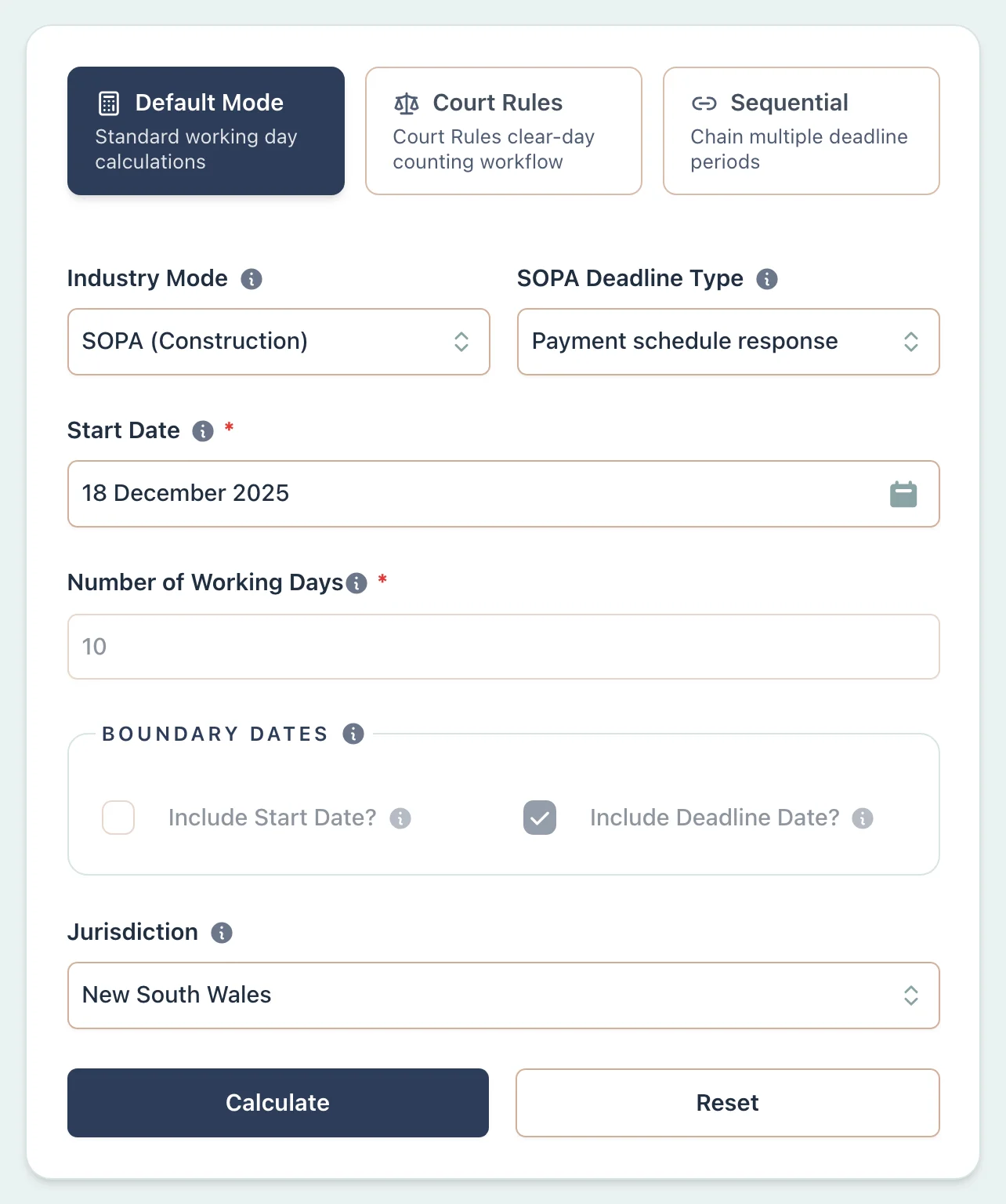

Settings, in form order
- Calculation type
- Deadline
- Use court rules
- Off
- Counting method
- Working days
- Jurisdiction
- New South Wales
- Local holiday area
- None
- Additional excluded periods
- Security of Payment — NSW/SA/ACT (27–31 December)
- Include the start date
- Off
- Include the deadline date
- On
- Start date
- 18 December 2026
- Number
- 10
- Unit
- Days
- Direction
- Forward

Result
Monday 11 January 2027
The NSW definition leaves out 27–31 December as well as weekends and public holidays. Check the contract for an earlier response period before relying on this date. This is the deadline for providing a payment schedule; the payment due date is a separate question.

Litigation solicitor: filing date across the summer exclusion (VIC)
A litigation solicitor in Melbourne is preparing a document for filing in the Victorian Supreme Court. A court order sets a 28-day filing period from 12 December 2026. The solicitor needs to plan the client's review and approval around the summer break. Rule 3.04 excludes 24 December to 9 January from the count unless the Court orders otherwise, and this order does not change that exclusion.

Settings, in form order
- Calculation type
- Deadline
- Use court rules
- On
- Court jurisdiction
- VIC Courts
- Court rule
- VIC Courts: Filing deadline
- Optional court rules
- Exclude 24 December–9 January
- Service date
- 12 December 2026
- Number
- 28
- Unit
- Days
Result

Wednesday 27 January 2027
With the start excluded and the end included, the ordinary 28-day count would finish on 9 January 2027. Rule 3.04 leaves all 17 vacation dates, 24 December 2026 to 9 January 2027, out of the count. The resulting date is 26 January, so the final-date rule moves it to Wednesday 27 January because Australia Day is a public holiday. Before calculating, confirm that the Service date is the legally correct trigger date and review How this will be counted, including the rule 3.04 exclusion. If the Court has ordered that the period be counted, turn the summer exclusion off and recalculate.

HR manager: multi-state consultation period across King's Birthday

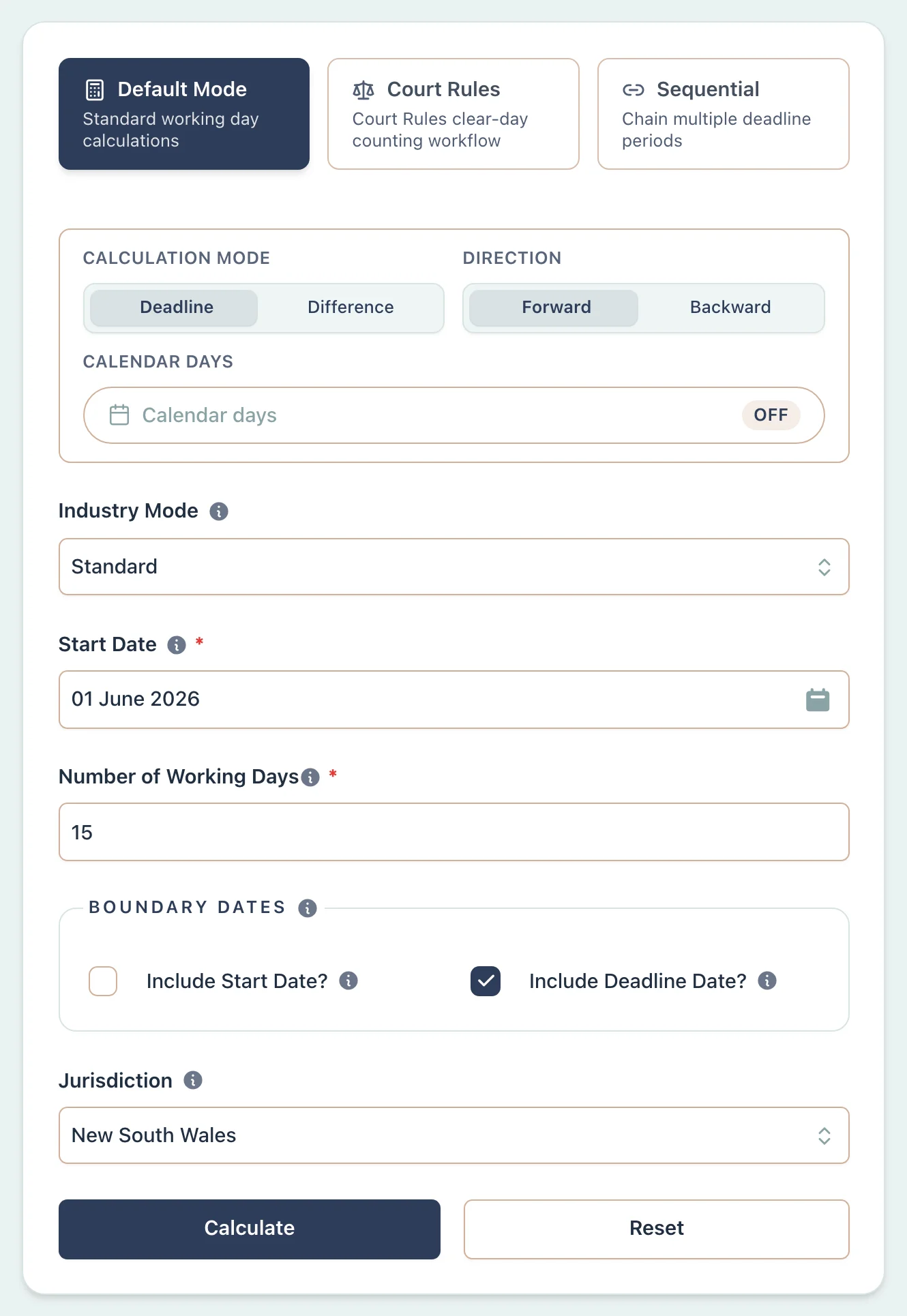

An HR manager is consulting staff in Sydney and Brisbane about a proposed roster change. Their enterprise agreement allows 15 working days for consultation from 1 June 2026. The manager needs to tell each team when responses are due. King's Birthday falls on 8 June in NSW but on 5 October in Queensland, so the Sydney team has an extra day to respond.
Settings, in form order
- Calculation type
- Deadline
- Use court rules
- Off
- Counting method
- Working days
- Jurisdiction
- New South Wales
- Local holiday area
- None
- Additional excluded periods
- None
- Include the start date
- Off
- Include the deadline date
- On
- Start date
- 1 June 2026
- Number
- 15
- Unit
- Days
- Direction
- Forward
Result

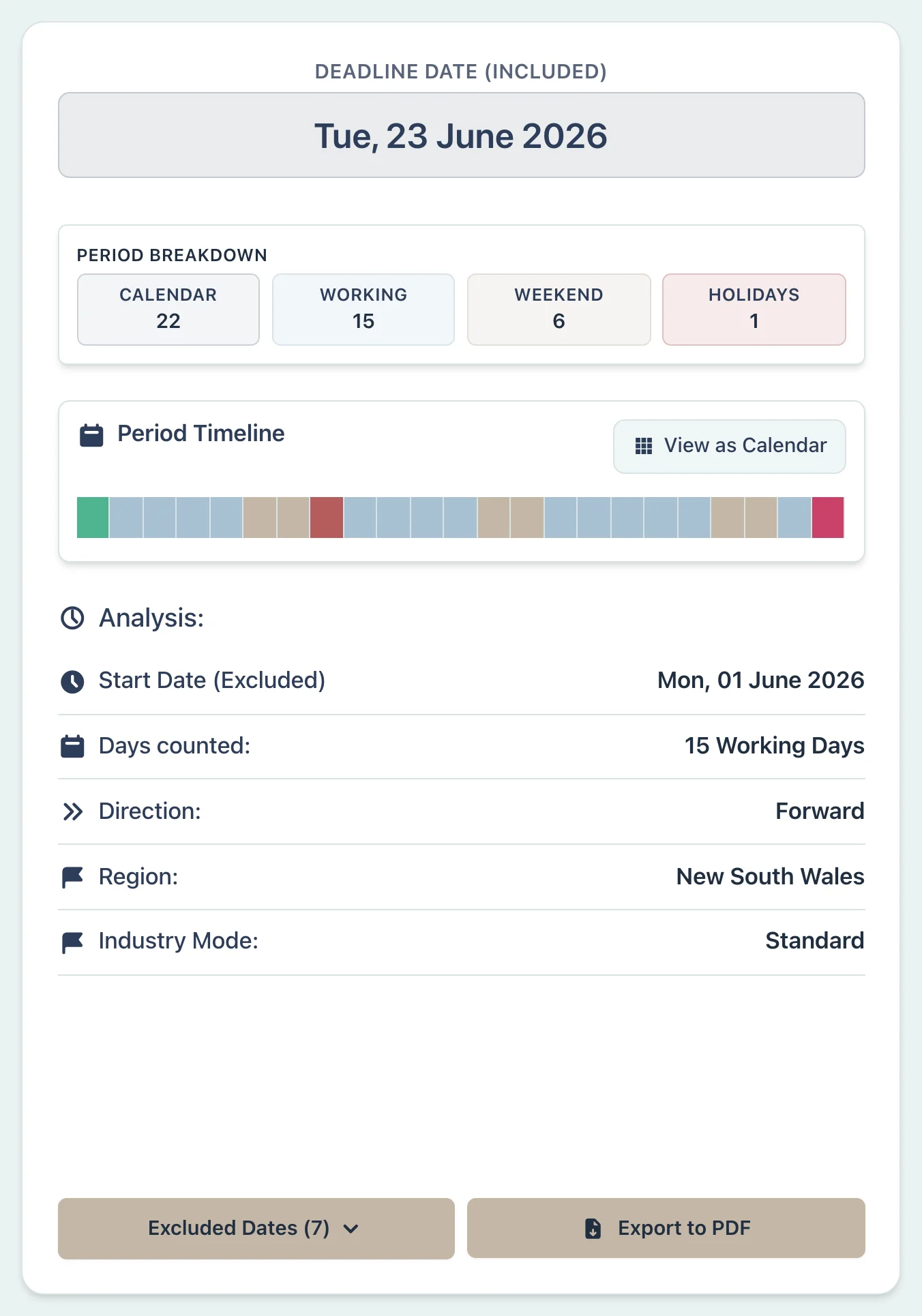

NSW deadline
Tuesday 23 June 2026
QLD deadline
Monday 22 June 2026
The NSW result is one working day later because 8 June is left out there. Use the calendar that applies to each workplace when setting its response date. Change Jurisdiction to QLD and recalculate.

Construction manager: contract milestone across Melbourne Cup day
A construction manager has projects in Melbourne and Geelong. A contract variation notice is issued on 27 October 2026, and each contract allows 10 working days for a response using the holidays at the project site. The manager needs a response date for each project. Melbourne observes Cup Day on 3 November. Greater Geelong's local holiday is on 21 October instead, before the notice was issued.
Settings, in form order
- Calculation type
- Deadline
- Use court rules
- Off
- Counting method
- Working days
- Jurisdiction
- Victoria
- Local holiday area
- None
- Additional excluded periods
- None
- Include the start date
- Off
- Include the deadline date
- On
- Start date
- 27 October 2026
- Number
- 10
- Unit
- Days
- Direction
- Forward

Result
General Victorian deadline
Wednesday 11 November 2026
Greater Geelong deadline
Tuesday 10 November 2026
The Melbourne count skips Cup Day. Geelong's local holiday has already passed, so its response is due one working day earlier. The contract or rule governs which locality applies. Check it before selecting the local holiday area. Select City of Greater Geelong in Local holiday area and recalculate.

Conveyancer: property settlement spanning Christmas (NSW vs SA)
A conveyancer is arranging two property settlements, one in NSW and one in South Australia. Both contracts were exchanged on 8 December 2026 and allow 20 working days for settlement. The conveyancer has checked that neither contract adds a separate Christmas shutdown and needs to book settlement around the public holidays. The two states use different holiday names, but the working-day counts give the same settlement date.
Settings, in form order
- Calculation type
- Deadline
- Use court rules
- Off
- Counting method
- Working days
- Jurisdiction
- New South Wales
- Local holiday area
- None
- Additional excluded periods
- None
- Include the start date
- Off
- Include the deadline date
- On
- Start date
- 8 December 2026
- Number
- 20
- Unit
- Days
- Direction
- Forward
Result

NSW settlement date
Friday 8 January 2027
SA settlement date
Friday 8 January 2027
Both counts leave out Christmas Day, the additional holiday on 28 December and New Year's Day. Boxing Day in NSW and Proclamation Day in SA fall on a weekend in this example. Check bank and PEXA availability separately. If the contract includes a Christmas shutdown, add it before calculating. Change Jurisdiction to SA and recalculate to compare the holiday name and result.

Contracts administrator: contract notice period spanning show days (QLD)
A contracts administrator is tracking responses for projects in Brisbane and the Gold Coast. Both contracts give 14 working days from 9 August 2026 and use public holidays at the place of work. The administrator has checked the start date under each contract and needs to confirm when each response is due. Brisbane's show holiday is the Ekka on 12 August. The City of Gold Coast has its own show holiday on 28 August instead.
Settings, in form order
- Calculation type
- Deadline
- Use court rules
- Off
- Counting method
- Working days
- Jurisdiction
- Queensland
- Local holiday area
- Brisbane City Council area
- Additional excluded periods
- None
- Include the start date
- Off
- Include the deadline date
- On
- Start date
- 9 August 2026
- Number
- 14
- Unit
- Days
- Direction
- Forward
Result
Brisbane deadline
Friday 28 August 2026
Gold Coast deadline
Thursday 27 August 2026
The Brisbane count leaves out the Ekka date, so its result is one working day later. The Gold Coast count does not leave out Brisbane's holiday. Its own show holiday falls after the 14th working day in this example. Change Local holiday area to “City of Gold Coast” and recalculate.

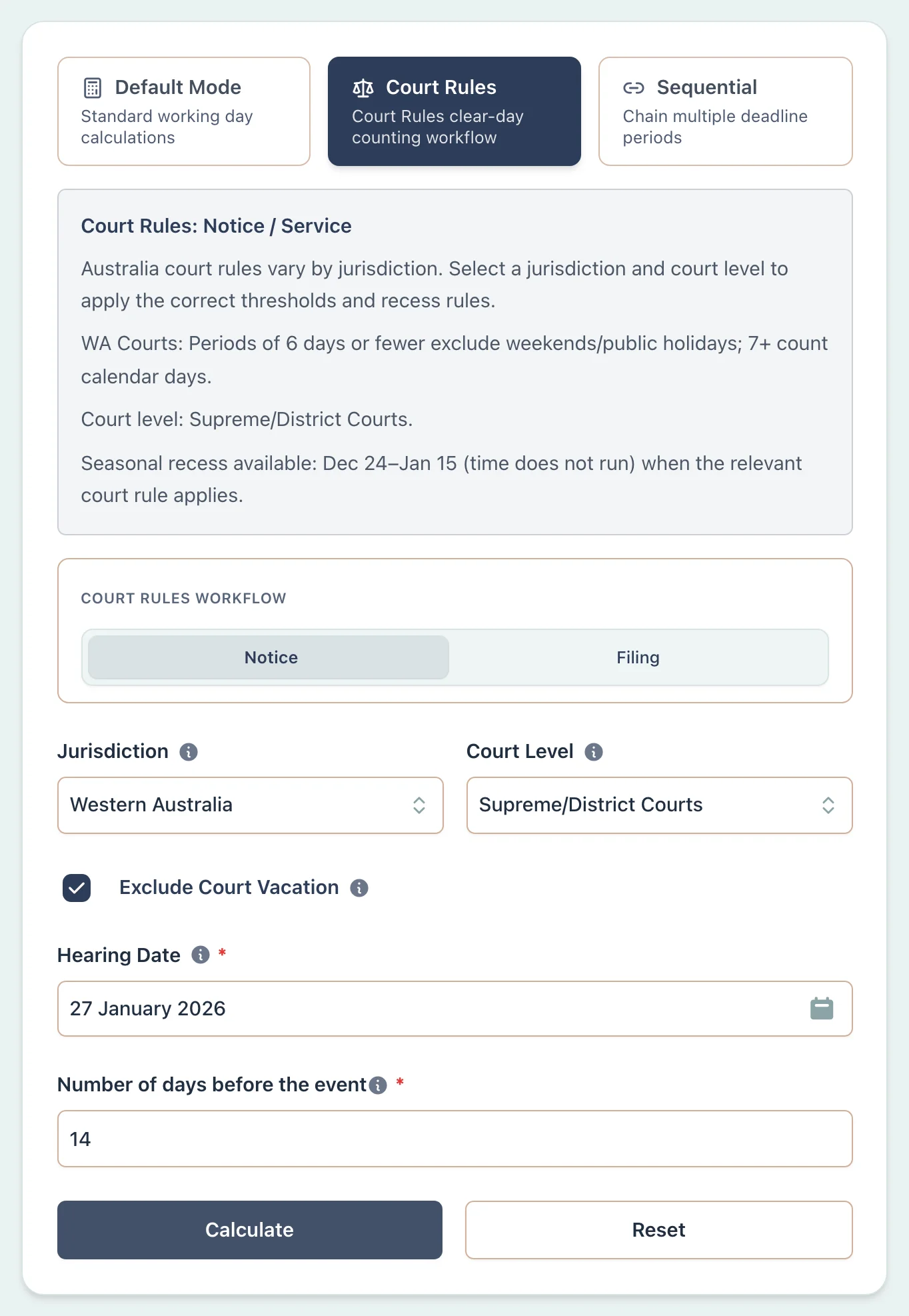

Litigation lawyer: plan pleading service before the summer break (WA)
A litigation lawyer in Perth is preparing a pleading for a WA Supreme Court hearing. The court order requires it to be served 14 days before a hearing on 27 January 2026. The lawyer has checked that Order 3 rule 3 applies and that the Court has not changed the 24 December–15 January exclusion. They need to arrange client approval and service before the summer break.
Settings, in form order
- Calculation type
- Deadline
- Use court rules
- On
- Court jurisdiction
- WA Courts
- Court level or registry
- Supreme/District Courts
- Court rule
- Supreme/District: Notice deadline
- Optional court rules
- Exclude Court Vacation
- Hearing date
- 27 January 2026
- Number
- 14
- Unit
- Days
Result

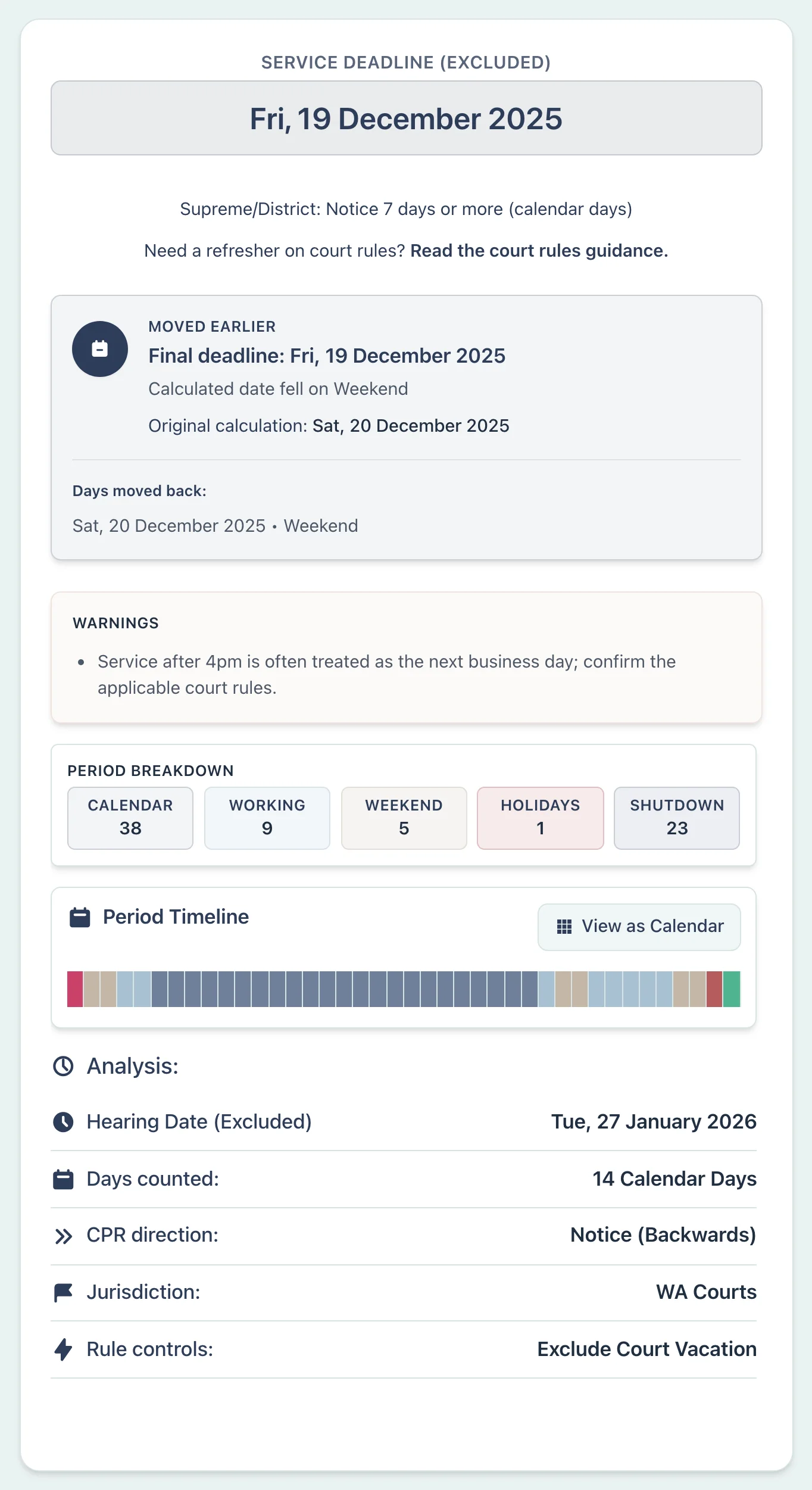

Friday 19 December 2025
With the optional vacation control selected, 24 December 2025 to 15 January 2026 is left out (23 days suspended). The count reaches Saturday 20 December. The calculator suggests Friday 19 December for service before the weekend. This is a planning date: check the order and service method before treating it as the legal deadline. Weekends remain in this 14-day count: WA's shorter-period rule applies only to periods of fewer than seven days. Before calculating, confirm that the document is a pleading covered by the vacation rule and review How this will be counted.
